4th Street -
Civic Campus
LATEST
NEWS/UPDATES
%20with%20sky.jpg)
Here you will find any and all information on our current progress and operations regarding the 4th Street Property. This site is best viewed in DESKTOP MODE.
Next Up...

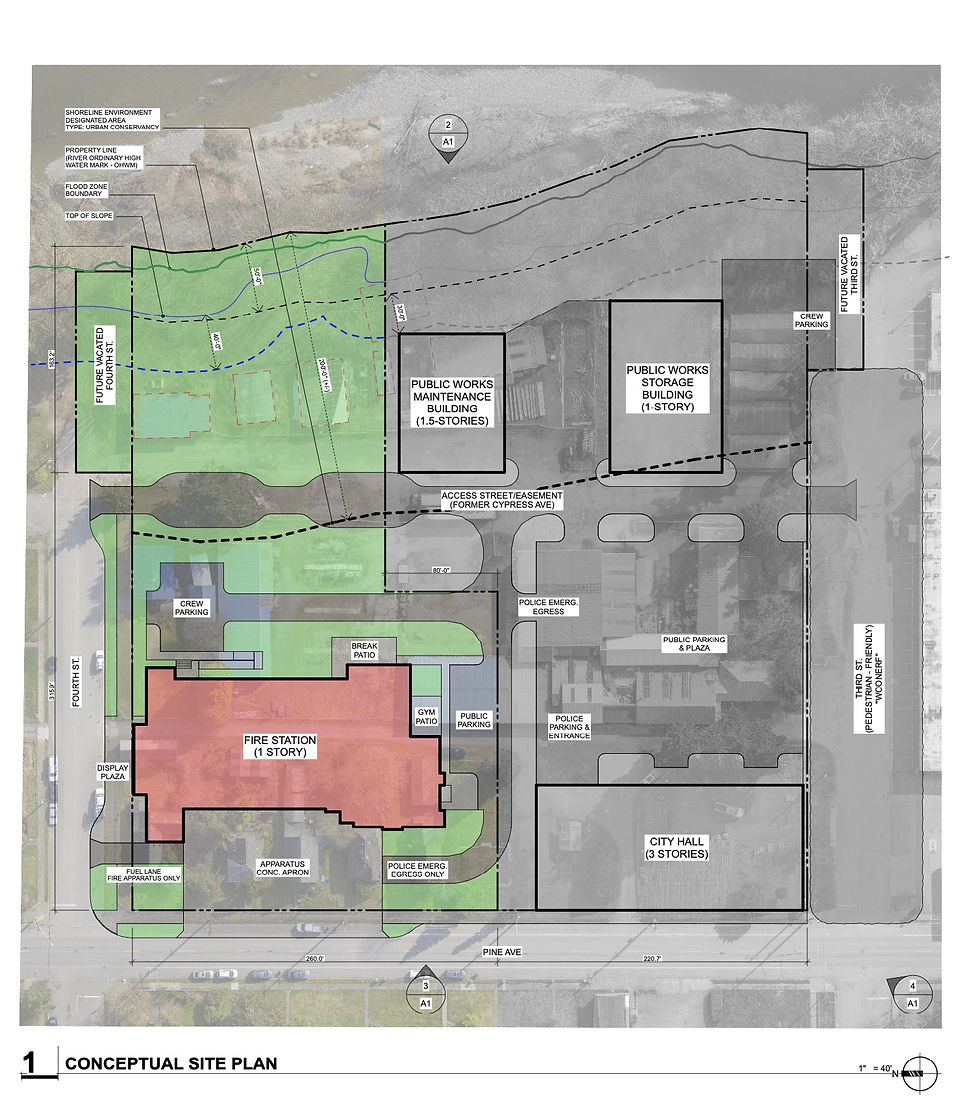

If you wish to see how the Fire District and the City's individual projects will look upon completion, thus forming the Civic Campus, follow the link below.
https://www.snohomishwa.gov/817/Public-Safety-City-Services-Campus

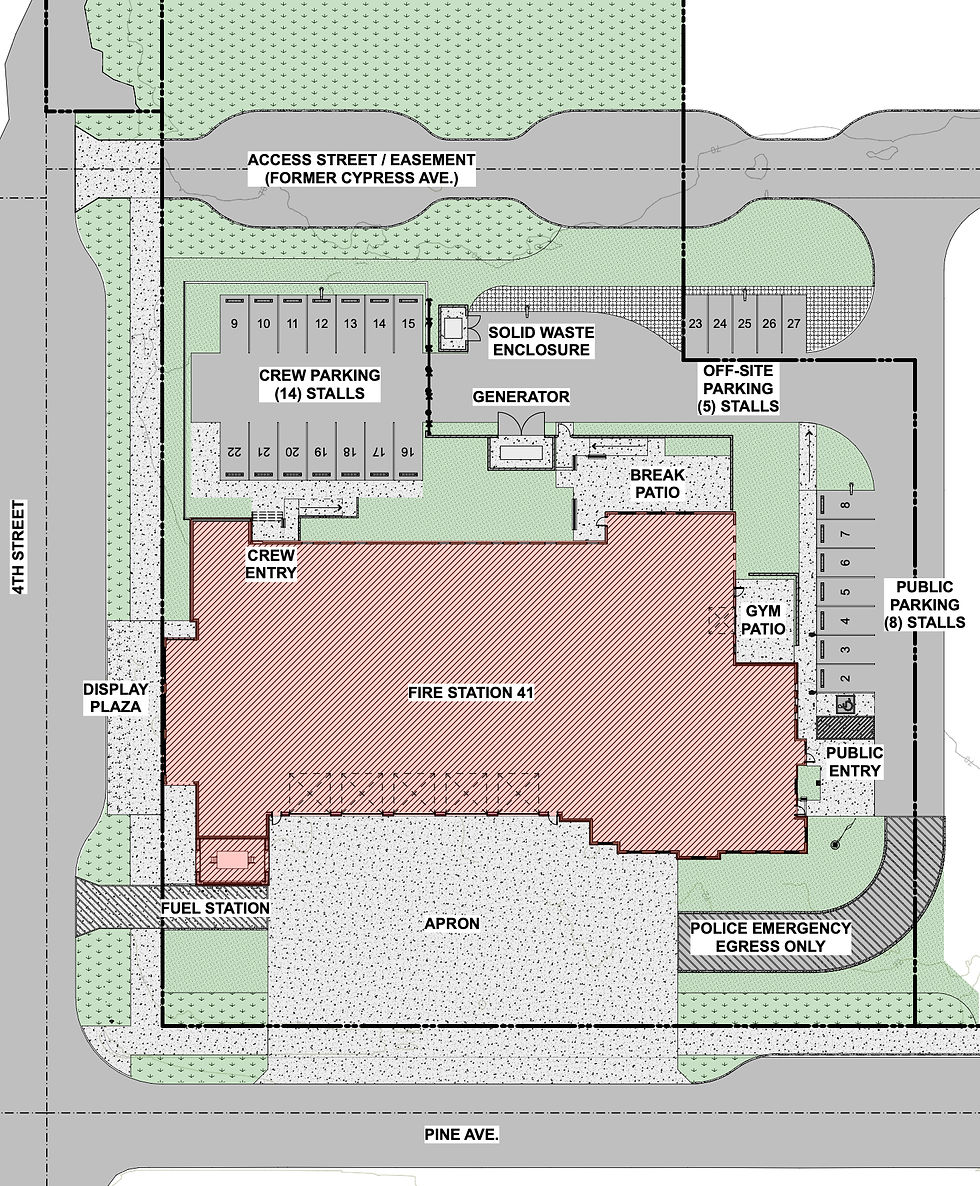

4th Street
Fire Station Progress
7.21.2025 - 7.25.2025
~ Schedule Update 7.30.2025 ~
Week of 8/4
-
Prepare for concrete flat work
-
Start of onsite Utilities
-
Start of Cypress Sewer
​
Week of 8/11
-
Continue Cypress Sewer
-
3rd St. Hydrant/ service install
-
Continue on site utilities
-
Install Cap Break/ Vapor Barrier
​
Week of 8/18
-
Fill & Test 3rd St. Water
-
Finish Cypress Sewer
-
Start Watermain on 3rd St. West of Pine/ Cypress
-
Continue on site utilities
-
Place 4" Slab on grade- concrete flat work
​
Week of 8/25
-
Continue Cypress water main install
-
Conduct 3rd St Tie-ins
-
Set Pine sewer bypass system up
-
Continue on site utilities
JULY 24, 2025
~ Schedule Update 7.24.2025 ~
Week of 7/28
-
Placement of the remaining foundation concrete
-
Prepare Interior Building Subgrade
-
Continue waterline on 3rd (crossing pine headed east bound on 3rd)
-
Start install of Old Cypress Sewer
-
4th St Water tie in
-
4th St Pavement Restoration
Week of 8/4
-
Start onsite Storm
-
Finish Old Cypress Sewer
-
Move sewer bypass to Pine Ave
-
Start Water Main on Old Cypress
Week of 8/11
-
Prepare for Slab on grade
-
Complete Water on Old Cypress
-
Start Sewer on Pine
-
3rd St water tie in
-
Pavement restoration on 3rd St
Week of 8/18
-
Place Building Slab on Grade
-
Start Framing Structure
-
Start Water on Pine Ave
-
Complete Sewer on Pine Ave
JULY 10, 2025
~ Schedule Update 7.10.2025 ~
Week of 7/14
-
Start of foundations
-
Install of water services on 4th/prepare for testing
-
Start of "old cypress" sewer system
Week of 7/21
-
Station foundation work
-
Complete "old cypress" sewer system
-
Start 3rd St. water main​
​
Week of 7/28
-
Continue foundation work
-
Start Pine sewer
-
Install water services on 3rd St.
Week of 8/4
-
Continue foundation work
-
Complete Pine sewer
-
Complete 3rd St. water
JUNE 27, 2025
~ Schedule Update 6.27.2025 ~
Week of 6/30
-
No major activities
Week of 7/7
-
Dirt work on site
-
Infrastructure work
Week of 7/14
-
Footing excavation will begin
-
Start footings
-
Water main install on 4th to begin
-
Sewer main on site between 3rd and 4th to begin
Week of 7/21
-
Complete water main of 4th
-
Continue Footings
JUNE 11, 2025
~ Schedule Update 6.11.2025 ~
Week of 6/16
-
Wrap up preload placement/ ensure pile is neat
-
Continue to monitor settlement
-
Haul off of top soil pile
Week of 6/23
-
Continue to monitor settlement
-
start water line on 4th Ave between Maple & Lincoln
Week of 6/30
-
Continue to monitor settlement
-
Install, test, & Inspect water main on 4th Ave between Maple & Lincoln
Week of 7/7
-
Continue to monitor settlement
-
Backfill water main on 4th Ave between Maple & Lincoln
-
Begin water stubs on 4th Ave between Maple & Lincoln
MAY 28, 2025
Basic Site prep and mobilization will begin on June 2nd. It will last around 2 weeks. The next phase will be the hauling (dump trucks) of fill into the site, which will also take about 2 weeks. Road and Utility work will likely begin in July after the Holiday. As we have more detailed information, we will update everyone.
~ Schedule ~
Friday 5/30/25
-
First couple pieces of equipment will be brought out to the site and stored
​
Week of 6/2/25
-
The earth working crew will be on site
-
Site fence will be installed
​
Week of 6/9/25
-
Begin to clear the site
-
Light trucking begins
-
Begin placement of structural fill
-
More trucks will start to show up
​
Week of 6/16/25
-
Heavy Truck presence remains
MARCH 29, 2025
***GROUND BREAKING CEREMONY***
For those who missed it, our ground breaking ceremony was a huge success! We were truly honoroed to see so many people taking time out of their day to join us in this momentous event.
While there are so many groups to thank for every effort put in to making this project come to life, we wish to make a special shout out to Jake Hensrude of ACE Equipment Rentals in Snohomish. Because of ACE's gracious donation, including delivery and pick up, the ground breaking was very unique with our very own GOLD excavator buckets! It was truly quite a hit!! Thank you so very much for your generosity and help in making Saturday truly memorable.
We also wish to extend our thanks to our Board of Commissioners, the City of Snohomish, the Snohomish Film Company, past and present elected officials, and so many more. The list truly does go on and on...
​
JULY 24, 2024
Plans are being finalized! The District is currently and frequently meeting with the architect to confirm final details and we are planning to break ground and start construction in the first quarter of 2025!
TIMELINE

PINE AVENUE
DEVELOPMENT TIMELINE
​
​
04/09/2024 Live Fire Training Begins
02/13/2024 Daily Training Begins
01/20/2024 Property Vacated by Tenants
12/13/2023 Security Fencing in Place
11/20/2023 Property Purchased
​
​
